SCIENCE ADDITION

February 16, 2000 Update

Science/Math:

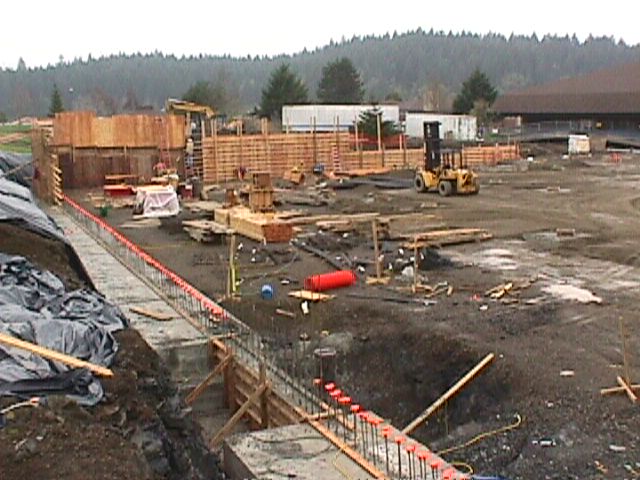

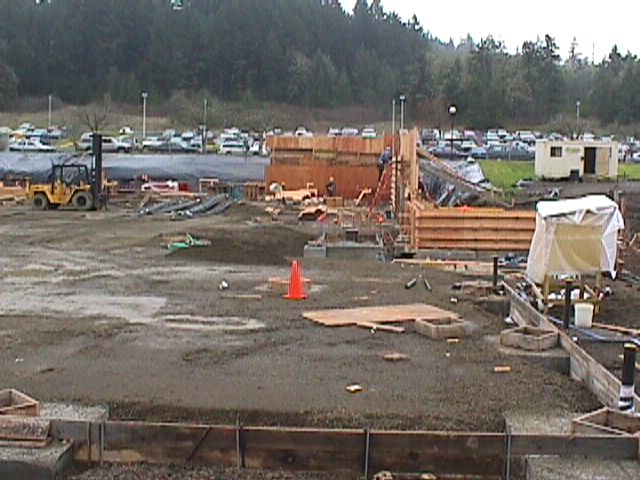

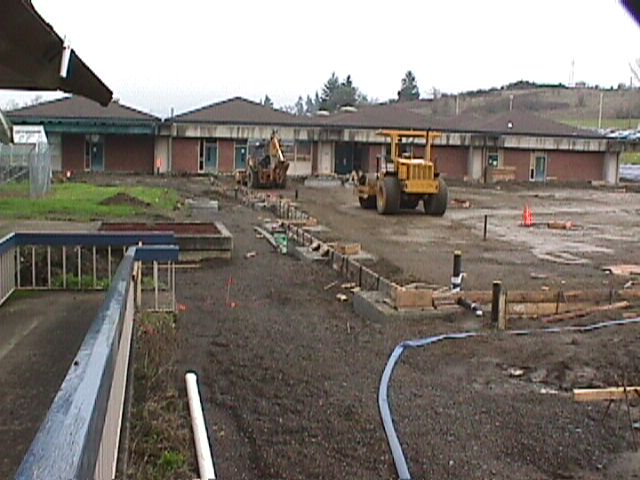

Foundations are more than half poured. Some retaining walls will be poured soon. Some plumbing work is being done under the existing building. Plumbers are working 5 to 8 a.m. to minimize disruption to classes. The project is now about five weeks behind schedule due to delays caused by the structural engineers.

Questions and comments about any bond construction activity may be directed to 744-4154 or e-mailed to
bond@lanecc.edu. All communication received will be regularly reviewed by the Bond Project Management Team (BPMT), the architects, and the Facilities Management Committee.
