Bond Update - November 2, 1999

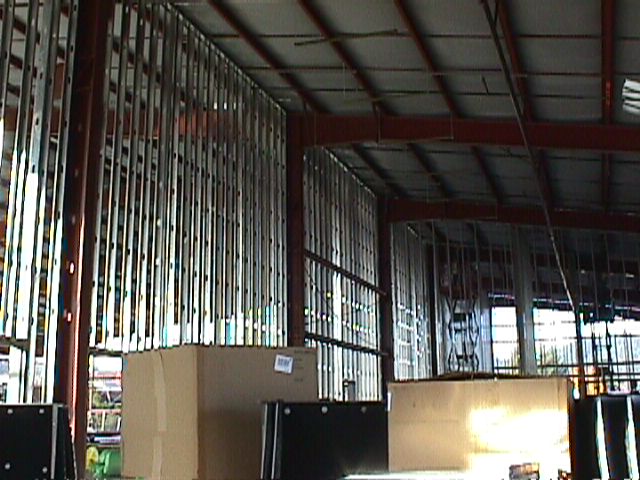

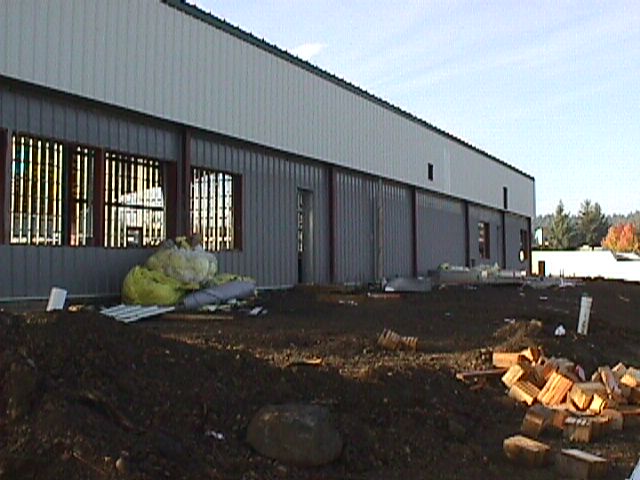

WELDING building roofing,

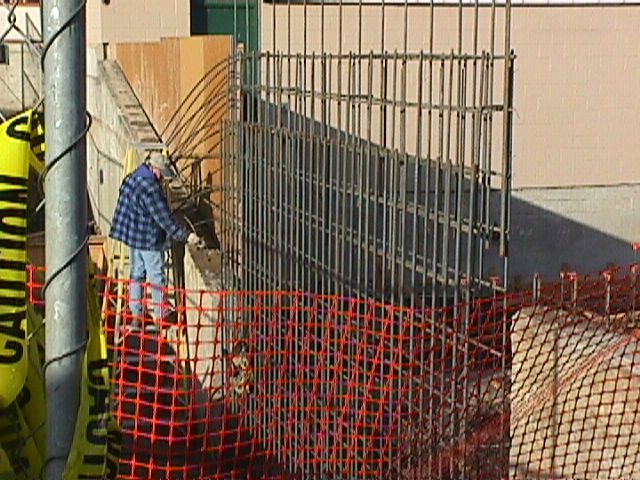

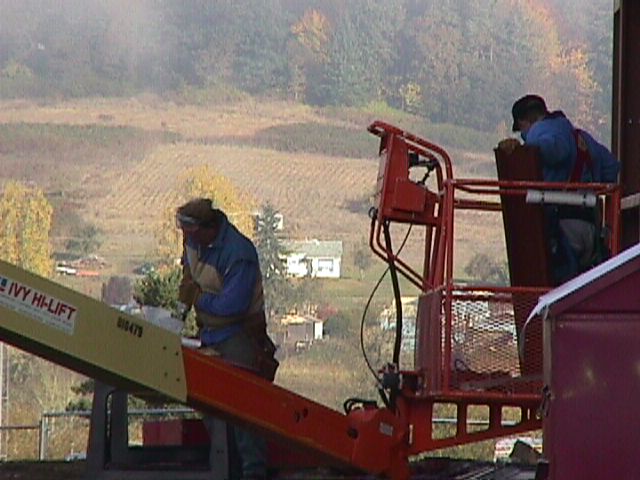

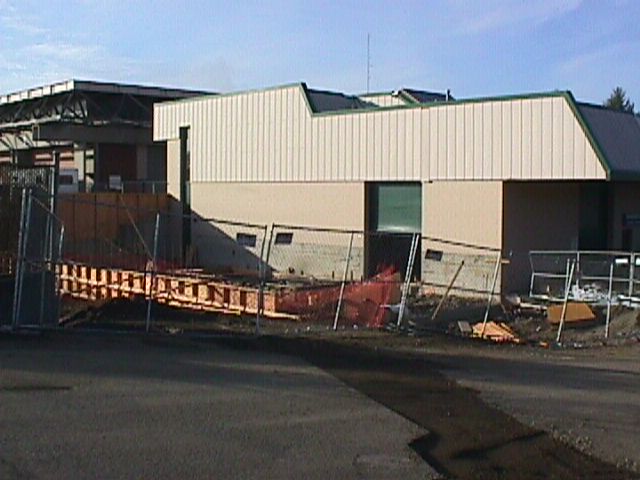

exterior siding and interior wall framing continues this week. The equipment yard and parking areas are paved. Construction is due to be completed by Dec. 31.
CAMPUS SERVICES ADDITION site work continues this week,

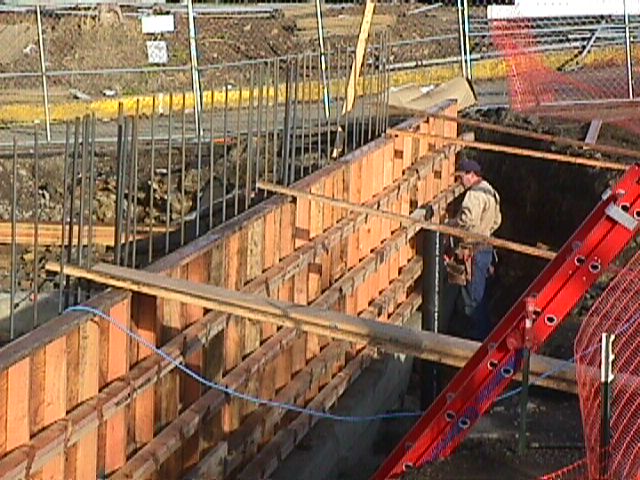

including more concrete pouring. Construction completion is scheduled for April 2000. Facilities superintendent Mike Ruiz and project engineers spared the college an $87,000 change order last week by figuring a better wiring route for power connections to the Campus Services Addition and Welding Technology Building. The change order resulted from an idea to link the power supply for Campus Services and Welding but Mike and the engineers found a better solution.
THE SCIENCE/MATH bid opening is Nov. 9.
If Responses are within budget and present no complications, the Board of Education will be asked to award the construction contract at its Nov. 10 meeting. A pre-bid walk-through was conducted Oct. 27. Bond Construction Project Manager Bob Mention says about 50 people attended, including 13 bidders and the rest subcontractors.
THE CHILD CARE PROJECT

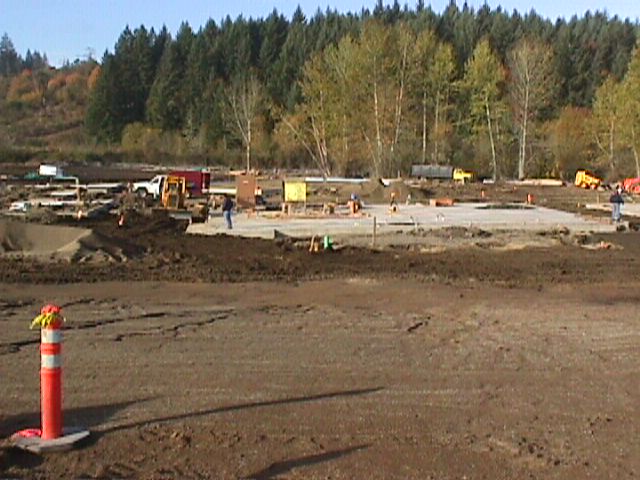

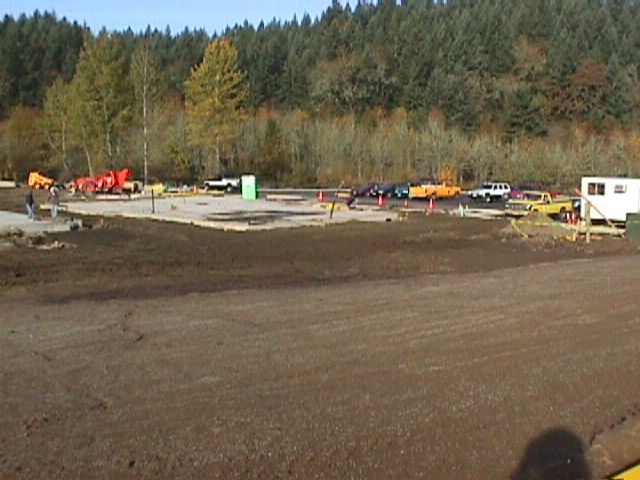

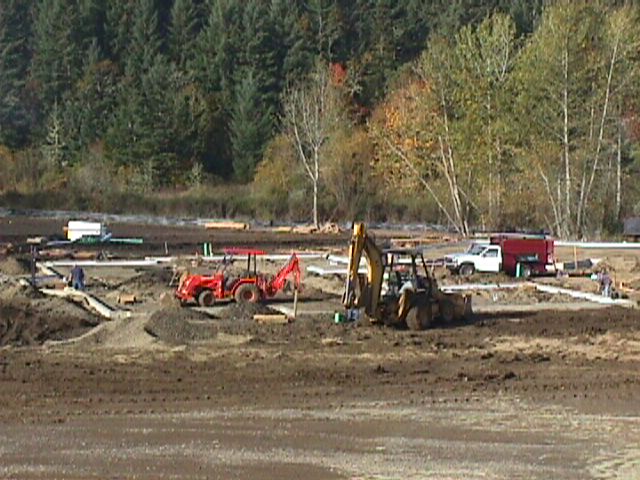

Concrete work continues for stem walls and slabs but look for a dramatic change around Nov. 11. That's when the contractor plans to erect walls for Building 1. The walls are being pre-fabricated by Oregon Dome (the building will not be a dome shape) and should go up in just one day. Roofing and other work will follow. Walls should go up for the other three buildings about every two weeks.
INFRASTRUCTURE
Electrical infrastructure upgrade bids are being prepared to go out this week. Upgrades are planned for telephone and TV cabling, clocks and fire alarms, and similar services. Bids will be opened just before Thanksgiving and contract awards will be scheduled for the December Board of Education meeting. Bond-funded infrastructure plans are dovetailing with additional college infrastructure plans including a campus wide-area network backbone upgrade.
ARCHIVES
Archives & Records Management should begin Phase III of its move into the off-campus records storage warehouse on Franklin Blvd. this week as Facilities crews move remaining boxes from the Science tunnel.
Questions and comments
about any bond construction activity may be directed to 744-4154 or e-mailed to
bond@lanecc.edu
. All communication received will be regularly reviewed by the Bond Project Management Team (BPMT), the architects, and the Facilities Management Committee.
