Bond Update - October 4, 1999
PARKING LOT improvements on the west side of campus
Await landscaping and lighting. The contractor has experienced a delay in obtaining a template for the light pole concrete bases, but has been instructed to provide temporary lighting fixtures, if necessary, by mid-October.
CHILD CARE buildings 1 and 2 now have foundations.
The contractor plans to finish these two buildings ahead of the others. Walls are being fabricated off-site to reduce on-site materials storage and to expedite construction. The prefabricated walls will go up in just one to two days. In other work, the contractor is planning to inject water into the trenches which contain the innovative ground-loop system which will be used in heating the buildings. The trenches currently have loose fill and saturation is needed to compact the soil for sidewalk and play area construction. This work should occur within the next couple of weeks.

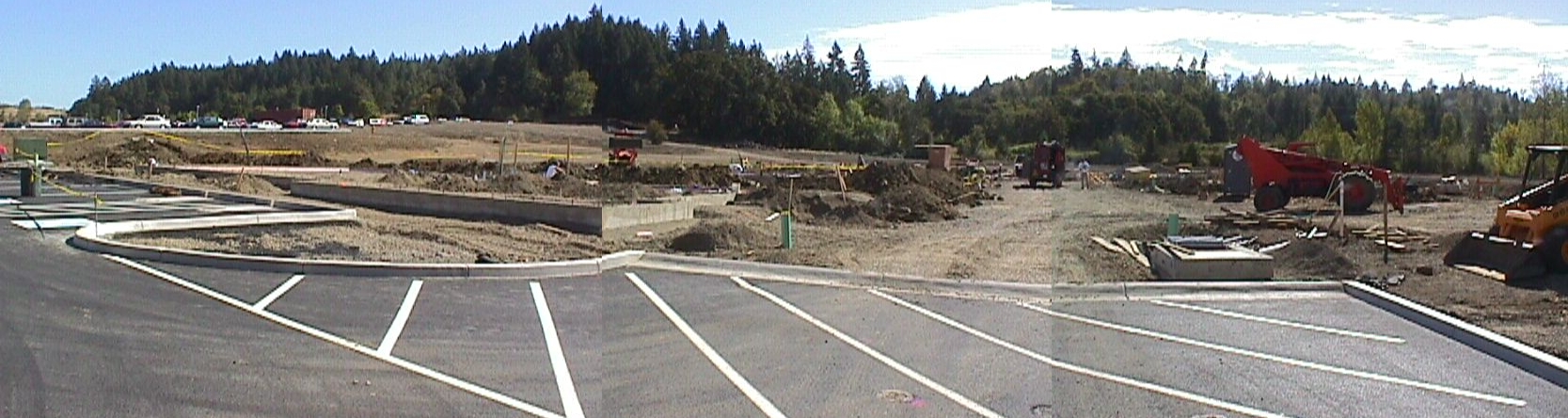

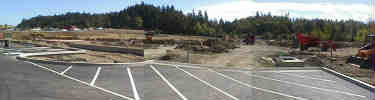

SCIENCE/MATH addition site work is complete.
The call for construction bids will be advertised October 10 and bids will be opened November 9. Bond management hopes to schedule user¿s group and Facilities Management Committee meetings to review the bids on November 10 for a possible contract award recommendation to the Board of Education that night.
WELDING has a high profile

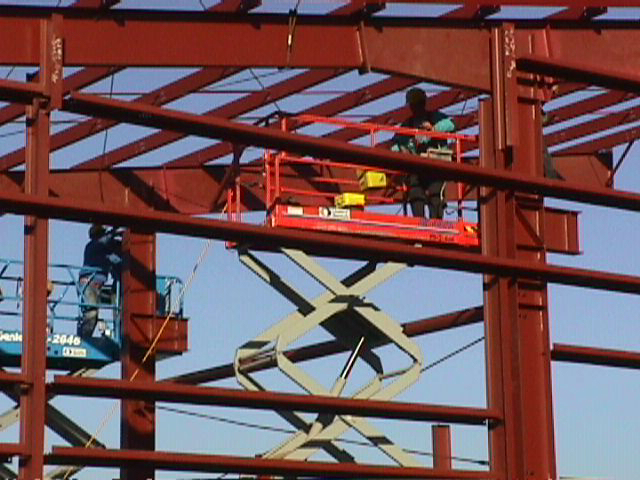

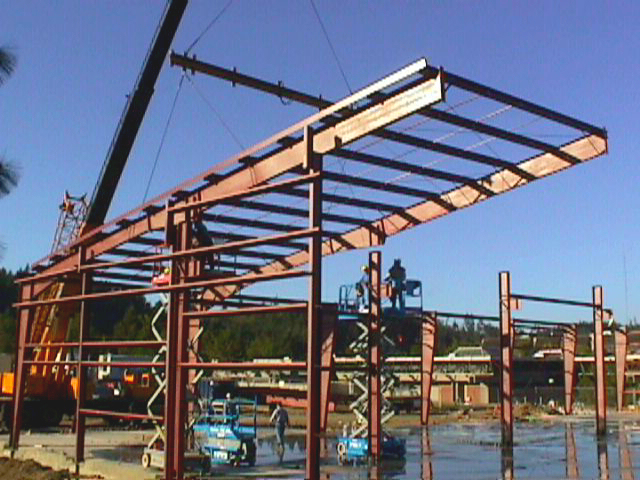

With erection of the red steel superstructure, including roof trusses. This week, additional metal framing will be added to exterior walls and some site clean-up and back-filling is expected. The contractor wants to secure a dry building as soon as possible before beginning interior work.
CAMPUS SERVICES ADDITION work raced along last week.

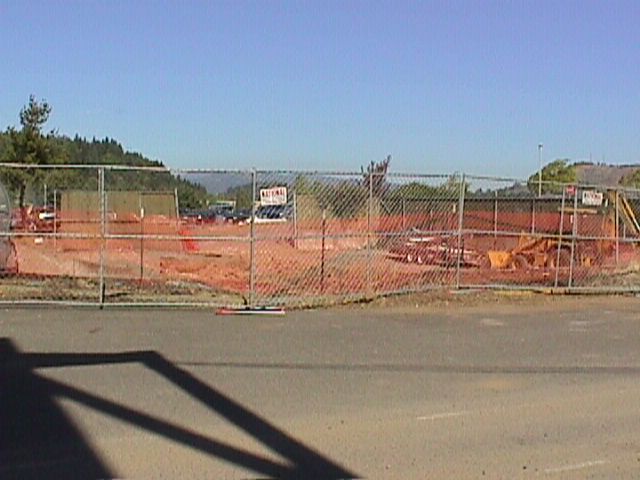

The contractor set up a job shack and conducted demolition and excavation work. About 250 yards more rock than anticipated has to be removed. Last week, crews also uncovered a conduit supplying power to the northeast parking lot lights. The conduit will have to be rerouted. Preparation for entrance into the existing building began last week, well ahead of schedule, and resulting in some earlier-than-expected moving of materials for Purchasing and the Warehouse.
Questions and comments
about any bond construction activity may be directed to 744-4154 or e-mailed to
bond@lanecc.edu
. All communication received will be regularly reviewed by the Bond Project Management Team (BPMT), the architects, and the Facilities Management Committee.

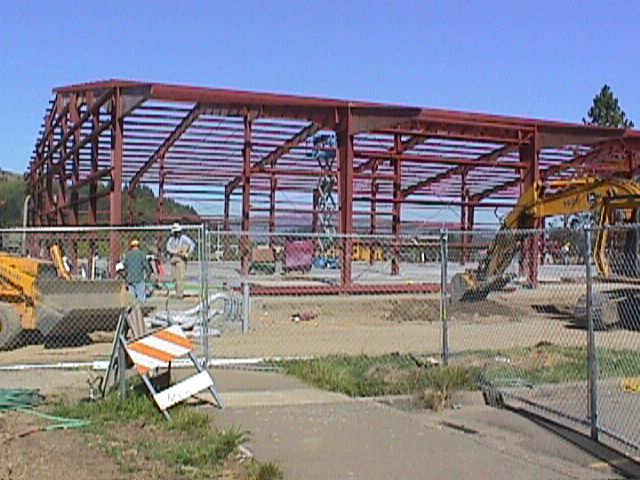

WELDING BUILDING

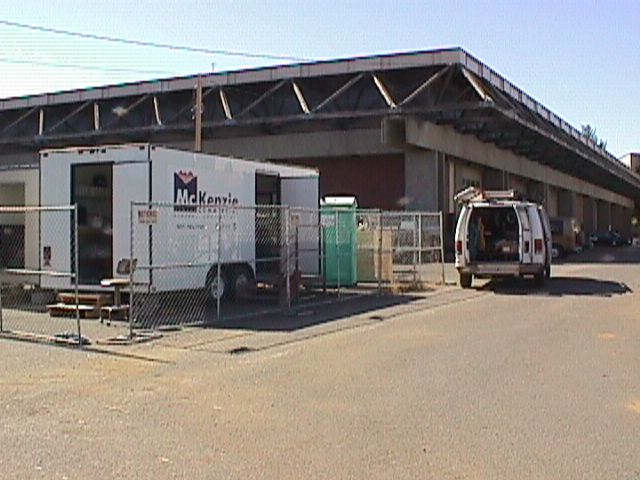

CAMPUS SERVICES ADDITION

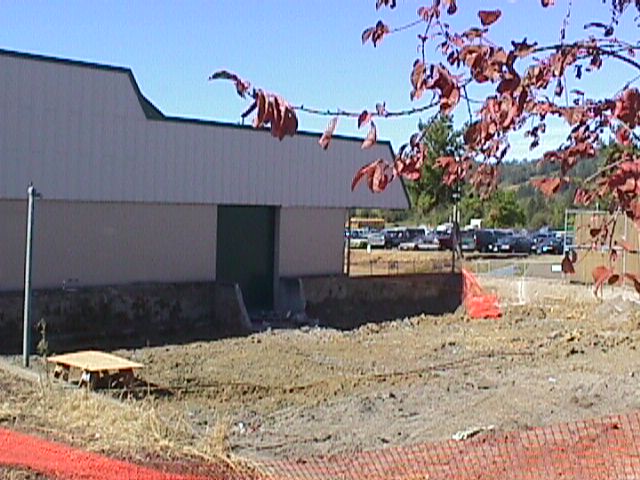

CHILDCARE FACILITY
Last Updated: October 4, 1999
